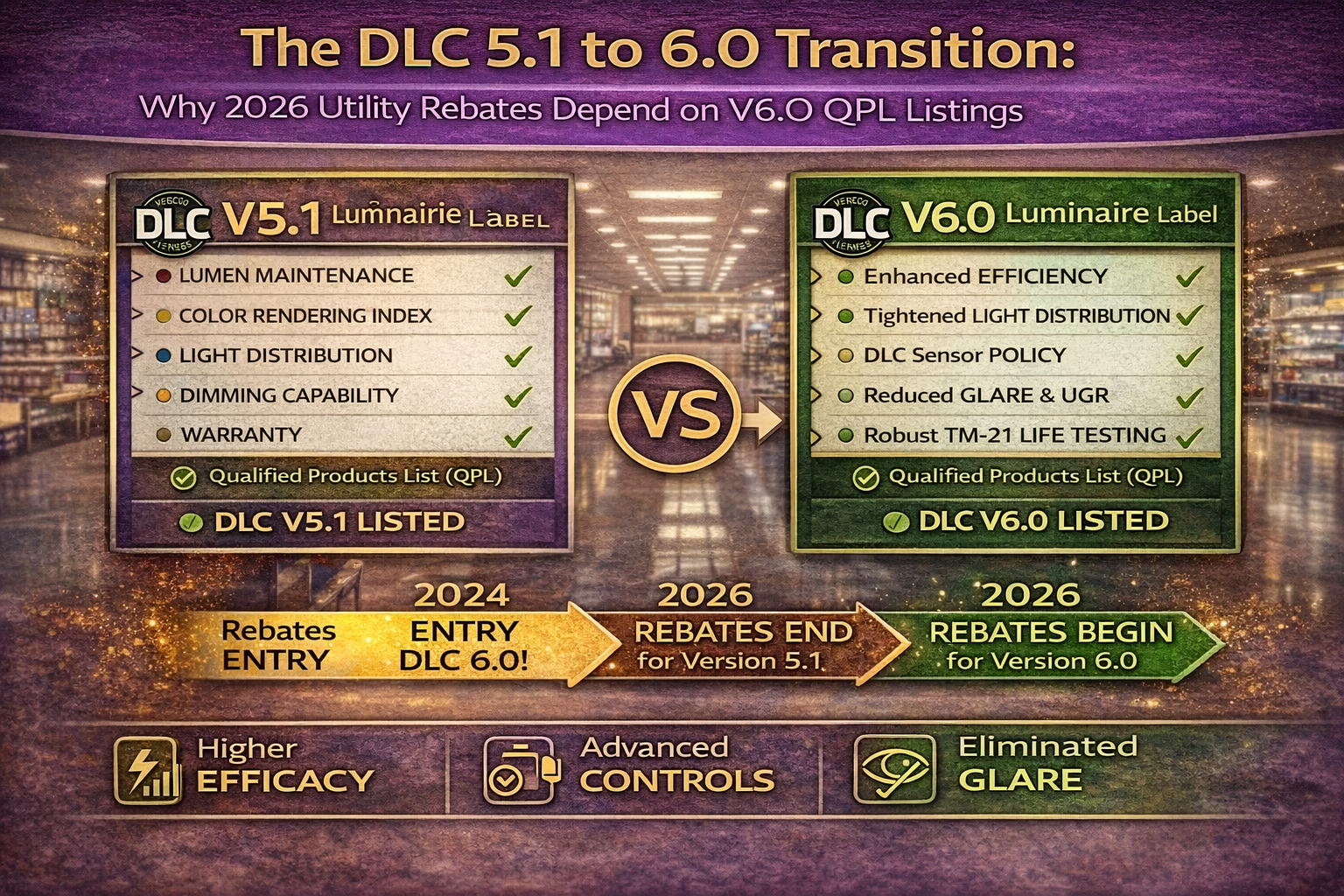

The DLC 5.1 to 6.0 Transition: Why 2026 Utility Rebates Depend on V6.0 QPL Listings

Brandon Waldrop
Infographic illustrating the transition from DLC 5.1 to DLC 6.0 lighting requirements, showing why 2026 utility rebates depend on products listed on the DLC V6.0 Qualified Products List

Why DLC Versioning Now Directly Impacts Project Economics

For commercial and industrial lighting projects, DLC qualification now functions as an eligibility threshold rather than an incentive add-on. As utility programs align rebate requirements with current DesignLights Consortium technical standards, the transition from DLC SSL V5.1 to SSL V6.0 directly affects incentive qualification, projected ROI, and product standardization across multi-site deployments.

DLC SSL V6.0 became the active standard on January 5, 2026, with SSL V5.1 scheduled for delisting on December 15, 2026. Products listed only under V5.1 may lose rebate eligibility as utilities update their qualified product list requirements. Projects dependent on incentives must account for this transition during specification to avoid mid-cycle disqualification.

  • Best practice: Require DLC SSL V6.0 listing in specs for any incentive-backed scope.
  • Risk point: Long lead times + phased installs amplify delisting exposure.
  • Documentation: Capture QPL listing evidence (screenshots/PDF exports) at submittal and at purchase.

Buying guide references: If your rebates are tied to common high-volume categories, use these workflows to keep layouts and compliance defensible: High Bay Lighting Buying Guide and Commercial Site Lighting Buying Guide.

What Changed from DLC 5.1 to DLC 6.0

DLC SSL V6.0 is not a cosmetic update. It raises performance expectations and expands documentation requirements so that rebate eligibility tracks durability, controllability, and verified performance—not just claimed watt-to-lumen math. DLC’s own overview of the SSL V6.0 release highlights higher efficacy thresholds and broader technical changes versus SSL V5.1.

Category DLC 5.1 DLC 6.0
Performance thresholds Legacy baselines Higher benchmarks across many categories
Criteria consistency More variation by category More standardized enforcement expectations
Reporting requirements More limited Expanded documentation and verification expectations
Future rebate alignment Decreasing support Becoming the default baseline for many programs

December 2026 Delisting of DLC 5.1 Products

DLC’s published workplan timeline lists SSL V5.1 delisting on December 15, 2026.

  • V5.1-only products can disappear from rebate lookup tools and utility-qualified lists as programs sync to the new baseline.
  • Multi-phase projects are the most exposed: a “good” SKU early can become a “non-qualifying” SKU later.
  • Operational reality: incentives are paperwork-driven—if the program requires V6.0 at submission, V5.1 status can break the financial model.

Why DLC 6.0 Is Critical for Rebate-Funded Projects

DLC SSL V6.0 is shown as effective January 5, 2026 on DLC’s workplan timeline. This matters because utilities and efficiency programs frequently reference DLC technical requirements as the baseline for incentives—and they update over time rather than preserving older versions indefinitely.

Project Scenario Risk Using DLC 5.1 DLC 6.0 Advantage
Single-site, fast retrofit Moderate Reduces surprises at submission
Phased rollout (6–18 months) High Keeps eligibility stable across phases
Portfolio standardization (multi-site) High Avoids re-spec and re-submittal churn

Project Risk by Timeline and Rollout Style

The main economic risk is not “whether DLC matters”—it’s when your program draws the line while you are still buying, installing, or submitting rebate documentation.

Timeline Factor Why It Matters What To Do
Long lead procurement Eligibility can change between spec and delivery Verify listing at submittal + at PO
Phased installs Phase 2 may fall under newer program rules Standardize on V6.0 early
Closeout paperwork delays Submission timing can control eligibility Build a “rebate-closeout” milestone into schedule

How to Protect Project Eligibility in 2026

Use a compliance-first process so incentives don’t collapse at the finish line.

Best Practice Why It Works What To Capture
Require DLC SSL V6.0 listing in the spec Reduces delisting exposure QPL ID / listing page proof
Verify listing at submittal, purchase, and closeout Prevents “status changed” denials Dated screenshots/PDF exports
Lock approved alternates to V6.0 as well Avoids value engineering breaking incentives Alternate matrix with QPL proof
Align controls and documentation early Many programs treat controls as required Controls narrative + cut sheets

Reality check: DLC’s timeline shows SSL V6.0 as effective in early 2026 and SSL V5.1 delisting in mid-December 2026. That combination is exactly why “V5.1-only” becomes a financial risk in long schedules.

As programs shift toward SSL V6.0, DLC versioning becomes a project-economics variable, not a marketing label. The safest path for 2026 planning is simple: specify DLC SSL V6.0 now, verify status at key milestones, and preserve documentation so incentives remain defensible through closeout.
